A Mullaly fibreglass pump station is made in one piece to your project specification, so installation on site is quick and cost-effective.
A Mullaly fibreglass pump station is manufactured as a one-piece construction to the exact specifications of your project, for a quick and cost-effective installation on site. Each one is delivered pre-packaged and ready for placement, with the pedestals, guide rails and pipework fitted to the approved project drawings.

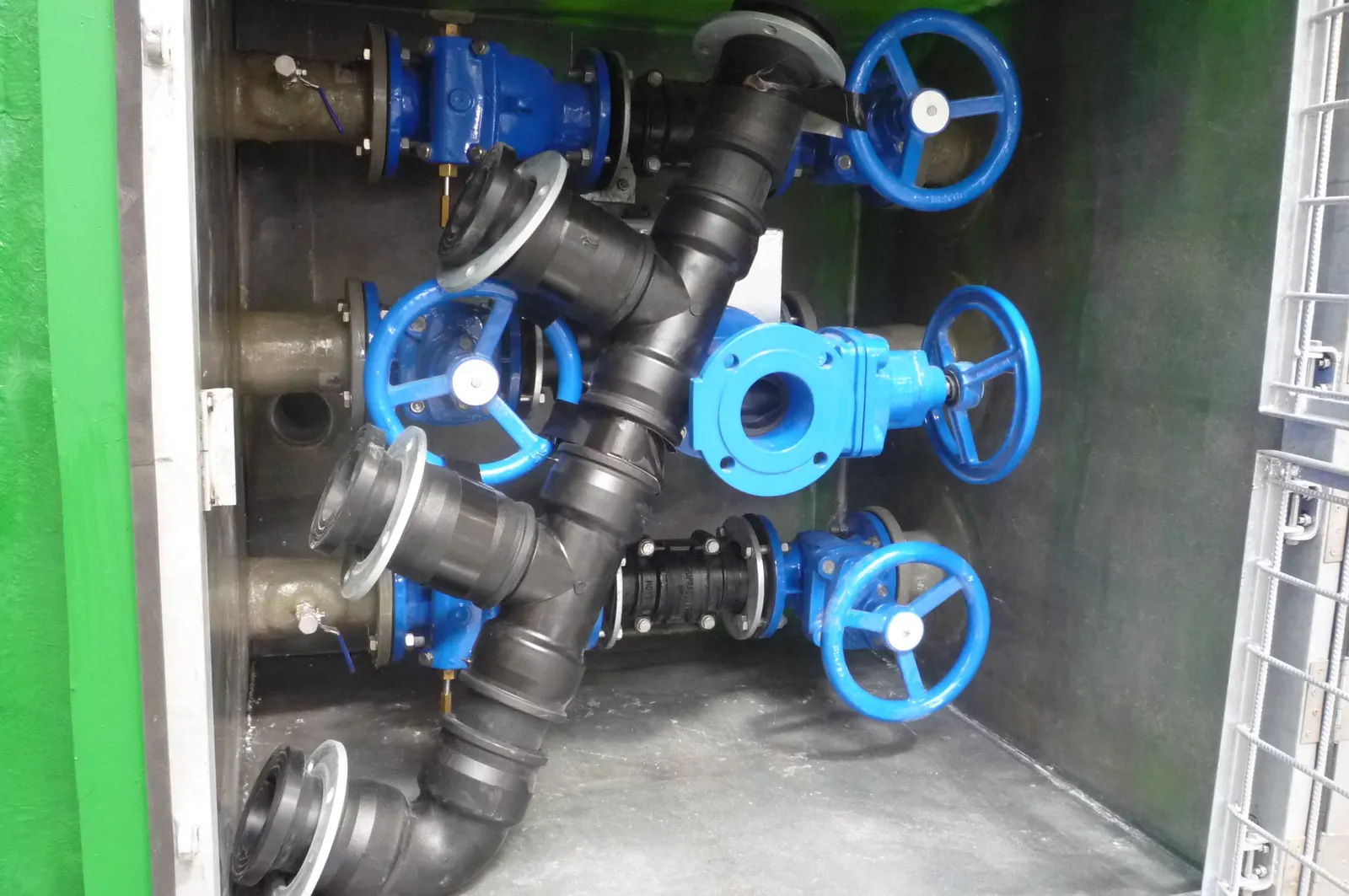

The integral valve chamber shortens excavation, reduces disruption to local flora and fauna and needs less space in the overall design, so the environmental footprint is smaller.
Mullaly FRP (fibre reinforced plastic) pump stations are engineered for sewage and water. They are independently verified to withstand internal and external loads, for a long design life. Mullaly FRP sewage pump stations are WSAA appraised (PA 1020 Issue 4, current to 2031) and designed to WSA 04-2022.

Mullaly FRP pump stations are designed to hold water and wastewater (sewage) and suit a wide range of applications, including:

WSAA appraised wet wells and valve pits for councils, utilities and developers.
View sewage pump stationsPump pits and pump stations for subdivisions, basements, roads and commercial sites.
View stormwater pump stationsUnderground fibreglass tanks for overflow and emergency storage at pump stations.
View underground tanksMullaly FRP pump stations can be configured with a range of additional features to suit your project.
The wet well and valve pit are built as one unit. Most projects suit a combo. The integral valve chamber shortens excavation and needs less space in the overall design, and because the two are one structure there is no differential settlement between the wet well and the valve pit.
A separate wet well holds the submersible pump or pumps for the wastewater system. It is used where a larger diameter is needed, and gives more flexibility in how the system is laid out.
Valve pits protect pipes and valves from the damage and corrosion that can happen when they are buried directly in the ground, and protect above-ground pipework from vandalism. A valve pit can be installed with a stand-alone wet well where transport limits rule out taking a combo pump station to site. Options include:
Macerators are often used in sewage systems to break solids into smaller pieces by grinding or blending, before the contents are pumped on. At Sydney International Airport Pier B we supplied a wet well, valve pit and macerator combo packaged pump station.

Manholes bring several wastewater sources into a single chamber with a single outlet. In gravity pipelines they can also provide a change in direction or grade. A Mullaly FRP manhole can be a cost-effective choice where:
Other benefits of a Mullaly FRP manhole:
| Item | Detail |
|---|---|
| Standard diameters | 1.5m to 3.75m (the WSAA appraisal covers external diameters from 1.2m to 4m) |
| Standard depths | 2m to 14m, with deeper pump stations available on request |
| Larger sizes | Engineered to project (Innes Estate, Townsville, 2007: a 4.0m diameter, 8.5m deep wet well) |
| Wall construction | Typically at least 20mm wall thickness, with a corrosion barrier incorporated as standard |
| Resin | Premium grade vinyl ester |
| Design | Designed and certified by a practising composite materials engineer. Designed to meet RPEQ requirements, with RPEQ certification available when required |
| Lids and covers | Aluminium access covers with lockable hinged lids and safety grates to AS 1664; ductile iron Class B, Class D or Class G covers. Class D cast iron covers are designed for vehicular traffic; standard aluminium covers are for pedestrian traffic only |
| Ballast | Engineer-prepared ballast calculations supplied with the installation instructions, to counter hydrostatic uplift |
| Design life | 100 years |
| Warranty | 30-year corrosion warranty (Mullaly pump station warranty TD_SPW_008). It applies to pump stations installed according to the Mullaly installation instructions, and any variation must be approved in writing by Tank Solutions before installation |
| Pumps and controls | Pumps, valves, controls, switchboards and other accessories to suit each water agency's requirements. We can help coordinate pumps, controls and switchboards through our distribution partners |
| Model | Diameter | Depth |
|---|---|---|
| ME150 | 1.5m | 2m to 14m |
| ME180 | 1.8m | 2m to 14m |
| ME200 | 2.0m | 2m to 14m |
| ME250 | 2.5m | 2m to 14m |
| ME275 | 2.75m | 2m to 14m |
| ME300 | 3.0m | 2m to 14m |
| ME375 | 3.75m | 2m to 14m |
Model range from the Mullaly FRP pump station technical data sheet (TD_TDS_020). Larger and deeper units are engineered to project.
Each Mullaly pump station is designed as a stand-alone unit for the internal and external loads on its site, by a registered practising composite engineer. Flotation is countered by external ballast, using the engineer-prepared ballast calculations supplied with the installation instructions. Any load on the roof is taken by a reinforced concrete slab spanning the station.
Before final design, we supply CAD fabrication drawings for your approval. They show the layout, a description and the location of every fitting and connection, and all levels. A detailed specification for the fit-out pipework is available on request.

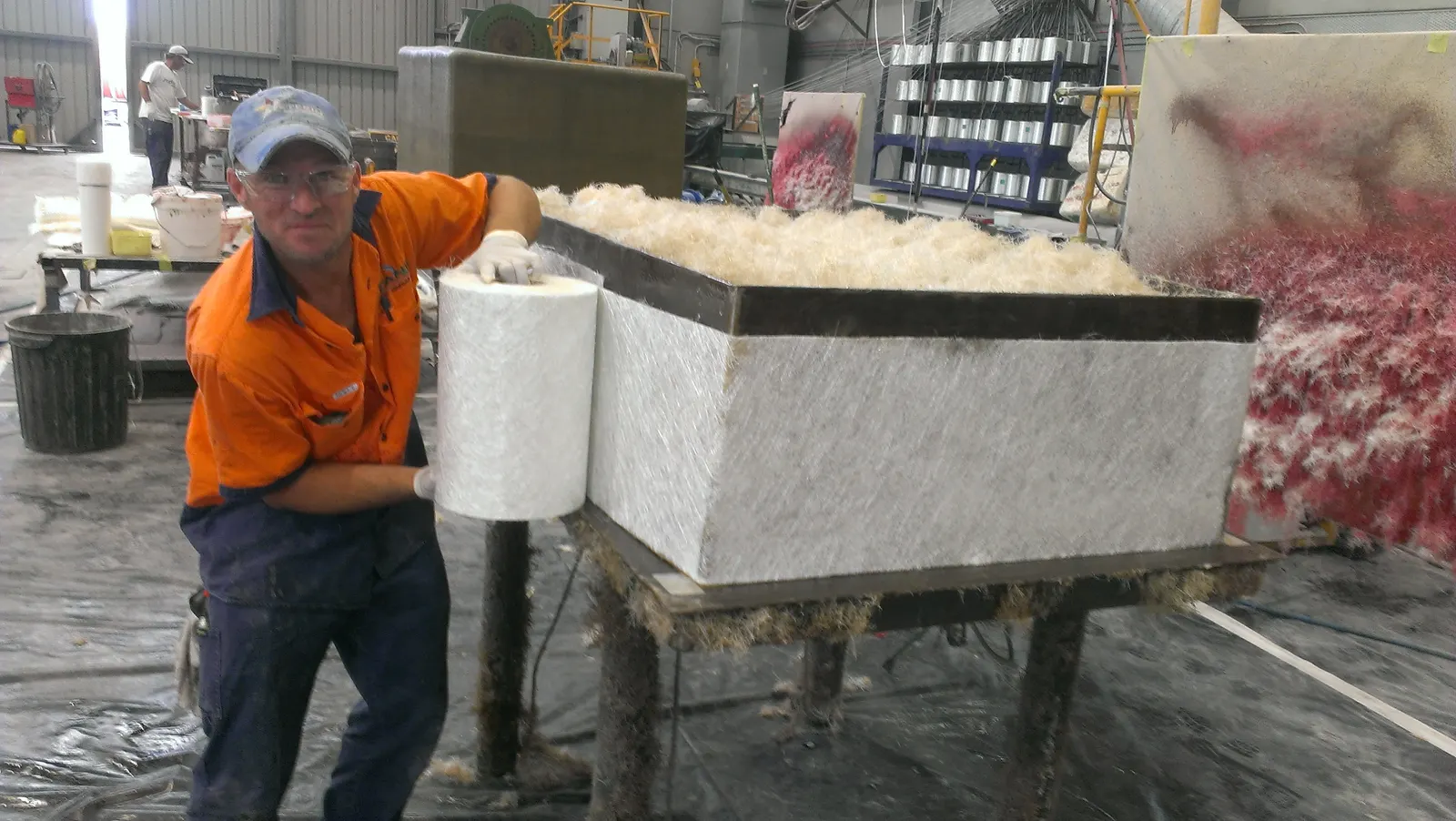

The station is then made in one piece in the factory and fitted out to the approved drawings, so it arrives on site ready for placement.

PA 1020 Issue 4, current to 2031. Designed to WSA 04-2022, the Sewage Pumping Station Code of Australia.
Vinyl ester resin resists the corrosive gases in enclosed wastewater environments, so surfaces and fittings need no sealing or coating.
One piece, solid wall from top to bottom. No joints between segments and no sealants applied on site.
Fitted out in the factory, so there is less need to enter the station or valve pit as a confined space.
In most cases set and backfilled within 1 to 2 days of delivery.
Smooth walls reduce scum build-up and resist abrasion from suspended grit. Design life is 100 years.
The pump station arrives in one piece with pipework, valves, pedestals and guide rails in place.
It is craned straight into the prepared hole, wet or dry.
Ballast is placed to the engineer-prepared calculations, then the hole is backfilled. In most cases this is done within 1 to 2 days of delivery.
The crew connects the external pipework and electrical work and installs the pumps.
For CAD drawings, ballast calculations or help choosing a pump station, contact our team. More documents are in the resource centre.






A pump station for a remote Arnhem Land community, still in near perfect condition 20 years later.
2019 · Sydney Airport, NSWA 3.0m dia x 5.0m deep combo on reclaimed land, levelled and ready for backfill in under an hour.
2020 · Townsville, QLDA 3m diameter, 6.2m deep wet well and valve pit combo, supplied fully fitted out for a busy stadium site.
